DIY · Paver Walkway

The easiest paver project to start with — and the one that teaches you everything.

A 3-4 ft wide paver walkway from driveway to gate, porch to patio, or side-yard to back-yard is the best first paver project a homeowner can take on. Same spec as a real patio, smaller footprint, faster win. Get this right and a future patio is just more of the same.

The honest version: Walkways have one trap patios don't: they need edge restraint on BOTH sides, not just a perimeter. Skip that and the pavers spread sideways the first time a kid rolls a bike across. Edge restraint, edge restraint, edge restraint.

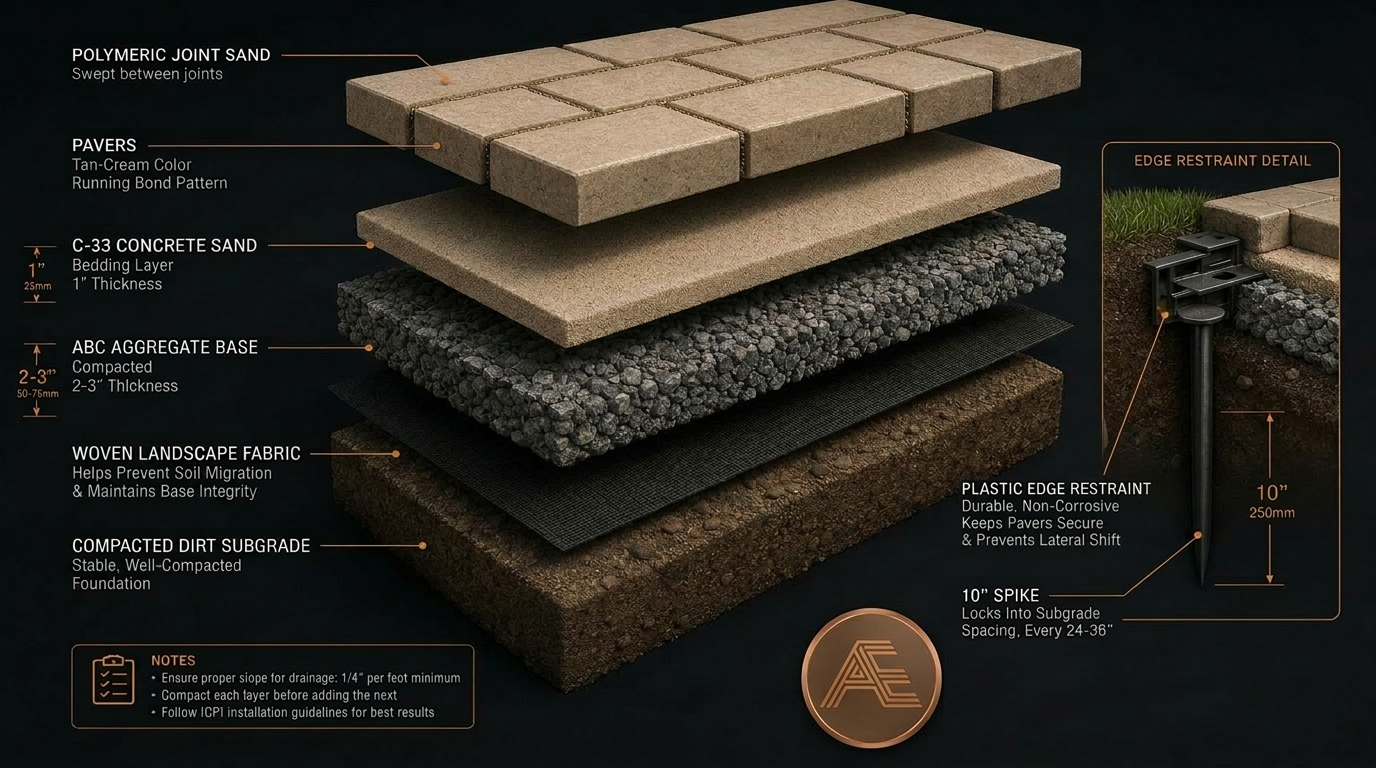

Exploded cross-section of an Arizona paver walkway assembly — compacted dirt subgrade, woven landscape fabric, 2-3 inches of ABC aggregate base, 1 inch of C-33 concrete sand bedding, pavers in running-bond pattern, polymeric joint sand, with a plastic edge restraint and 10-inch spike detail
Walkway assembly — same spec as a patio, smaller footprint, with edge restraint on BOTH long sides.
01

Why a walkway is the perfect first paver project

Small footprint, simple geometry, two weekends of work, and you bank every skill you'll need for a future patio. The exact same spec applies: 2-3" compacted ABC, 1" C-33 sand bed, polymeric joint sand, edge restraint. Master those four on a 90 sq ft walkway and a 300 sq ft patio becomes the same project, just bigger.

02

The walkway-specific traps

Walkways have two failure modes patios don't share. First: edge migration — without restraint on BOTH sides, the pavers spread sideways the first time a wheelbarrow, bike, or stroller rolls across. Patios have a perimeter that mostly stays put; walkways have two long edges, both under stress. Second: pitch direction. A walkway runs FROM somewhere TO somewhere, and the pitch (drainage) has to go to the right side. Always pitch away from the house, not along the walkway's length — water needs to come OFF the walkway, not run down it.

03

When you should hand this one to us

  • Driveway pavers — different spec entirely (4-6" ABC, vehicle-load edge restraint, herringbone pattern for shear resistance).
  • Walkways with steps, level changes, or that integrate with retaining walls.
  • Curved walkways over 30 ft long — the cuts get expensive and the layout precision benefits from a pro.
  • Front-of-house walkways where the finish quality is on display from the street.
Your investment — tools & materials

Tools you'll need

  • Plate compactor (vibratory)Rentable
    3,000 lb force class minimum. The single most-skipped tool — and the #1 reason DIY walkways settle.
    $70/day rental · $700 buy
  • Hand tamper (8x8 steel)
    For tight spots and edges where the plate compactor won't reach.
    $45
  • Wet saw or paver splitterRentable
    Trim end-cuts at gates, posts, and curves.
    $55/day rental
  • Rubber mallet (white)
    Seats pavers without scuffing.
    $15
  • Screed pipes (1" EMT, 2x 10 ft)
    Rails for screeding the 1" sand bed.
    $12 pair
  • Screed board (straight 2x4)
    Pulls flush with screed pipes.
    $8
  • 4-ft level + string line + stakes
    Alignment and slope (1/4" per ft away from house).
    $45
  • Wheelbarrow + flat shovel + landscape rake
    Standard material-moving kit.
    $140
  • Leaf blower (small)
    Clears polymeric joint sand off paver faces before activation.
    $80 (own)
  • Garden hose with mist nozzle
    Activates the polymer in joint sand.
    $30
  • Knee pads + gloves + safety glasses
    Don't skip the knee pads. Trust us.
    $60

Rentable items are available at most Home Depot / Sunbelt locations by the day.

Materials

  • ABC (Aggregate Base Course)
    Canonical walkway spec: 2-3" compacted. NEVER quarter minus — that's a turf base.
    A 3-ft x 30-ft walkway (90 sq ft) at 3" compacted ≈ 1.5 tons. Order 2 tons.
    $35–$50 per ton delivered
  • C-33 concrete sand
    1" sand bed, screed exactly. Bagged or bulk.
    $8–$12 per cu ft bag · $40/ton bulk
  • Pavers (rectangular or modular)
    Belgard, Pavestone, Acker-Stone, Techo-Bloc. Plan 5% waste for cuts.
    $3.50–$8 per sq ft
  • Polymeric joint sand
    Alliance Gator Maxx, Techniseal HP NextGel. Locks joints, blocks weeds.
    $35–$50 per 50 lb bag (covers ~80 sq ft)
  • Plastic edge restraint + 10" spikes
    Snap-Edge or Pave Edge Rigid. Non-negotiable on both sides of the walkway.
    $8 per 8 ft section
  • Woven landscape fabric
    Goes between subgrade and ABC.
    $50 for 4×100 ft roll
  • Marking paint + flags
    Layout.
    $15

Realistic DIY material + rental cost for a 90 sq ft (3 ft × 30 ft) walkway: $550-$1,100 depending on paver selection. Pro install for the same walkway: $1,800-$3,200.

Step-by-step
  1. Spray-paint the walkway outline. Call Arizona 811 (free, required) at least 2 business days before digging. Walkways frequently cross irrigation laterals and low-voltage lighting wire — both are easy to repair if you know they're there, expensive when you find them with a shovel.

  2. Total dig: 1" sand + paver thickness (~2-3/8") + 3" ABC = roughly 6.5" below your final walkway height. Make the trench 6" wider than your finished walkway on each side to give the edge restraint room to anchor.

  3. Compact bare subgrade with the plate compactor in two perpendicular passes. Lay woven landscape fabric edge-to-edge across the trench bottom, lap any seams 6".

  4. Spread ABC in 1.5" lifts. Compact each lift separately (the plate compactor only fully consolidates the top 2" of any one lift, so two thin lifts beat one thick one). Mist with water between lifts. Final compacted depth: 2-3". Slope subgrade and ABC together away from any adjacent structure at 1/8-1/4" per foot.

  5. Two 1" EMT pipes parallel down the walkway, ~3-4 ft apart. Pour C-33 sand between them, screed flush with a 2x4. Lift pipes, hand-fill the channels with sand. Do not walk on the screeded bed.

  6. Set pavers tight, no spacing. Tap each one home with the rubber mallet. Check pattern and edge alignment every 4-5 rows. Make end-cuts and angle cuts last with the wet saw.

  7. Walkways migrate sideways the moment a kid drags a bike across. Snap the L-channel against the outside row on each side and drive 10" spikes through it every 12". This is the part most DIY walkways skip — and the reason their pavers spread open at the joints by year two.

  8. Sweep coarse sand into joints. Lay a 1/4" rubber pad or sacrificial plywood over the walkway and run the plate compactor over the entire surface, two perpendicular passes. This locks every paver into the sand bed.

  9. Pour, sweep into joints until full, then BLOW (leaf blower, low setting) every grain off the paver faces. Any haze left will set permanently. Mist with a hose in light, repeated passes until the surface stays wet for 30 seconds. Cures hard in 24 hours.

  10. Keep traffic off for 24 hours. After 30 days you can apply a paver sealer if you want richer color and less long-term maintenance. Re-seal every 12-18 months in AZ sun.

Pro tips from our crew

  • Walkways are the BEST first paver project — small footprint, fast win, real skills banked for a future patio.
  • If you're connecting two existing surfaces (house slab to driveway), get the start and end elevations right BEFORE digging. Use a string line at both ends and dig to it.
  • For a curved walkway, lay the pavers first, then mark the curve with marking paint on top of the pavers, then cut all the perimeter pieces at once on the wet saw. Don't cut piecemeal.
  • Pull pavers from 3-4 cubes at once and blend — single-cube laying creates visible color bands.
  • Work in the morning. Polymeric sand activation gets sketchy above 95°F ambient.
  • Buy 10% extra pavers. Returns are a pain; running out at hour 4 is worse.

Common DIY mistakes we get called to fix

  • Quarter minus or decomposed granite as the base. Pavers need ABC; settling is inevitable with DG.
  • Skipping the plate compactor and 'tamping with a 4x4.' Expect visible sinking by year two.
  • Edge restraint on only one side, or none at all. The walkway spreads, weeds invade joints, pavers wobble.
  • Mason or play sand for the bedding instead of C-33 concrete sand. Mason sand holds water; you get a soggy, unstable bed.
  • Skipping landscape fabric. Fines from the subgrade pump up through the base over time and the walkway shows 'tea bag' settling around stress points.
  • Polymeric sand activated with a flood spray. Washes the polymer out of the joints — empty joints in 6 months.
  • Walkway pitched toward the house instead of away from it. Monsoon water now drains into your foundation. Always slope away.
When to call us instead

If your walkway starts feeling like more than a weekend, that's normal.

Most homeowners who start one of these projects finish it. Some realize halfway in that the prep, the equipment rental, or the physical scale isn't worth their Saturday. No judgment — we built our business on doing it right the first time. If you'd rather hand it off (or you've started and want a clean takeover), send a few photos and we'll quote it honestly.

FAQ

Common questions.

36" minimum for single-file traffic, 42-48" for comfortable two-abreast, 60" if it's the primary front-walk approach to the house. Wider walkways read as more 'designed' and don't cost much more in materials.

Compacted gravel that's clearly an old base layer (uniform stone, visible compaction, no organics) — yes, you can screed sand directly on it. Loose dirt, lawn, or recent fill — no, you need to excavate to firm subgrade and build the proper base. The 'shortcut' install always sinks.

Running bond with rectangular 4x8 or 6x9 pavers. Every other row is offset by half a paver, end-cuts are simple, looks intentional. Avoid herringbone or basketweave for your first project — they require more precision at the edges and waste more material on cuts.

In most Arizona jurisdictions, at-grade paver walkways on private property do not require a city permit. HOA architectural review is usually required even when the city doesn't care. Always confirm with your specific city and HOA before starting.

Same spec, same depth (2-3" compacted ABC + 1" C-33 sand). The only difference is geometry — walkways are narrower so the plate compactor works in fewer passes and the cuts are simpler. Driveways are completely different (4-6" ABC for vehicle loads); never use walkway spec under a driveway.

October through April. Walkways are smaller than patios so you can sometimes get a single-day install through a cool spell in May or September, but the polymeric joint sand step is the constraint — it only sets correctly between 32°F and 90°F surface temperature, and a sun-baked walkway in July reads 130°F+ by mid-morning. Schedule the polymeric day for a cloudy morning if you have to push into shoulder season.

Buy: rubber mallet ($18), 4-ft level ($35), tape measure, screed boards (rip two straight 2x4s), wheelbarrow, masonry chisel + 3-lb hammer, knee pads, and a $40 angle grinder with a diamond blade. That kit covers 90% of a walkway. Rent: plate compactor ($55–$75/day) — still required even on a small walkway, no way around it. Skip the wet saw unless you have a lot of curve cuts; the angle grinder handles straight cuts and 45s fine. Use spiked steel edge restraint from Ewing or SiteOne instead of the big-box plastic kits — half the price, twice the hold.
