Compare · Glass Railing Engineering

Glass pool fence spigots: core-mount vs bolt-down kits that fail.

The single biggest reason glass railings fail in Arizona isn't the glass — it's the anchor. A core-mount spigot embedded in concrete behaves as part of the structure; a surface-mount bolt-down kit fights the slab every day and loses. Here's the engineering, with exploded views.

The honest version: Most of the wobbly, leaning, rust-streaked glass railings we get called to rescue are Amazon bolt-down kits installed by a handyman two or three summers ago. The hardware was never wrong for somebody's tradeshow display. It was wrong for a 110°F pool deck guarding a drop. Spend the money once on a real core-mount install and you stop thinking about it.
01

Core-mounted and bolt-down glass spigot systems

Core-mounted and bolt-down systems are two common approaches. The appropriate mounting method depends on the existing structure, deck construction, engineering, manufacturer requirements, applicable code, site conditions, and signed proposal.

  • Core-mounted: a cylindrical stainless-steel spigot embedded into a core-drilled pocket and locked in with structural epoxy grout. The spigot becomes part of the concrete. When AE specifies this approach on a Sonoran Glass project, Duplex 2205 stainless-steel spigots are typical; the specific hardware for your project is confirmed in the signed proposal.
  • Surface-mount bolt-down (Amazon kits): a square base plate that sits on top of the slab and is held by four short wedge or lag anchors. The hardware fights the slab instead of moving with it.
02

Why glass shifts on a bolt-down install

Concrete is not static. A Phoenix pool deck cycles 40–50°F every day, more across the seasons. Every cycle the slab expands and contracts, and every control joint opens and closes by a measurable fraction of an inch. A core-mount spigot is inside that movement — the spigot, grout, and concrete behave as one. A surface-mount base plate is bolted on top of it. The four anchors work back and forth in their holes thousands of times a year. Within 18–36 months the holes are oversized, the panel develops a lean, and the railing fails plumb. You can see it most clearly at the gate posts: the panel next to the gate is the first to drift because it absorbs the slam load every time someone walks through.

03

Why bolt-down anchors fail on glass railings

  • Pull-out strength: a 3/8" wedge anchor in 4" of slab is rated at roughly 1,200–1,500 lbs at install — and that rating drops 30–50% after cyclic loading.
  • Guard load requirement (IRC R301.5 / IBC 1607.8): 200 lb concentrated + 50 lb/ft uniform at the top of the railing — multiplied by leverage from a 42" tall panel, that's thousands of foot-pounds at the base.
  • Bolt-down concentrates that load into four points on the slab surface. Core-mount distributes it through the full embedment depth of a footing.
  • Cracked concrete around the anchor heads is the telltale — once you see it, the anchor is no longer carrying the rated load.
04

Chloride-resistant stainless for glass railing spigots

  • Arizona pool decks are a chloride environment: chlorine, salt-water pools, sunscreen, monsoon dust, fertilizer overspray.
  • 304 stainless tea-stains in the first season and pits at the base within 18–24 months.
  • Chromed zinc (the giveaway on cheap Amazon kits) fails in under a year — the chrome plating flakes, then the zinc corrodes white.
  • Our current Sonoran Glass standard is Duplex 2205 stainless-steel spigots, which have a higher chloride-pitting resistance number than 304.
  • The specific spigot, wedge, and fastener metallurgy on your project is confirmed in the signed proposal — mixed metals at the same joint can galvanically corrode.
05

1/2-inch tempered safety glass for pool fence railings

  • Deflection under load: 1/2" panels feel solid when an adult leans on them. 3/8" panels noticeably flex at the same load.
  • Edge strength: tempered glass is weakest at the edge — thicker panels have more cross-section carrying the clamp force, so chips and spontaneous failures are rarer.
  • Heat-soaked: heat-soaked tempered reduces the (already small) risk of spontaneous breakage from nickel sulfide inclusions.
  • Certified: every panel we install ships with an ANSI Z97.1 or CPSC 16 CFR 1201 Cat II stamp etched in the corner. No stamp, no install.
  • AE's current Sonoran Glass standard is 1/2" tempered; 12mm imported panels are the metric-market equivalent and appear on other systems.
06

Side-by-side: core-mount vs bolt-down spigot comparison

  • Anchorage — Core-mount: spigot embedded in an epoxy-grouted concrete pocket. Bolt-down: 1.5–2" wedge anchors on slab surface.
  • Hardware grade — Core-mounted (AE Sonoran Glass typical spec): Duplex 2205 stainless-steel spigots. Bolt-down kits: typically 201/304 stainless or chromed zinc.
  • Glass spec — Core-mounted (AE Sonoran Glass typical spec): 1/2" heat-soaked tempered, certified. Bolt-down kits: 3/8" tempered, often uncertified import.
  • Code rating — Core-mount: engineered to meet 200 lb concentrated guard load. Bolt-down: sold as 'decorative,' not code-rated.
  • Year 2 — Core-mount: plumb, solid, looks new. Bolt-down: measurable lean, corrosion at base plate, anchor cracks in slab.
  • Year 10 — Core-mount: rinse, squeegee, service hardware as needed. Bolt-down: replaced.
  • Total installed cost — Core-mount: higher up-front, single install. Bolt-down: lower up-front, plus the rescue install when it fails.
07

What a proper core-mount glass spigot install looks like

  • Layout marked from the structural drawing — spigot centers, gate posts, panel widths, expansion gaps.
  • Core-drill pockets sized and depth-set per the engineered detail for that project's substrate — never into a thin unreinforced pool-deck slab.
  • Vacuum the pockets clean — no concrete dust, no standing water.
  • Two-part structural epoxy grout pumped into the pocket, spigot seated plumb, held until initial cure (~30 minutes).
  • 24-hour full cure before glass is loaded.
  • Panels set with stainless-steel wedges and rubber liners, torqued to manufacturer spec — not by feel.
  • Heat-soaked 1/2" tempered panels, certified, with polished edges.
  • Self-closing, self-latching gate hardware where the run is acting as pool barrier. Gate hardware is quoted separately and confirmed in the signed proposal.
Exploded engineering views

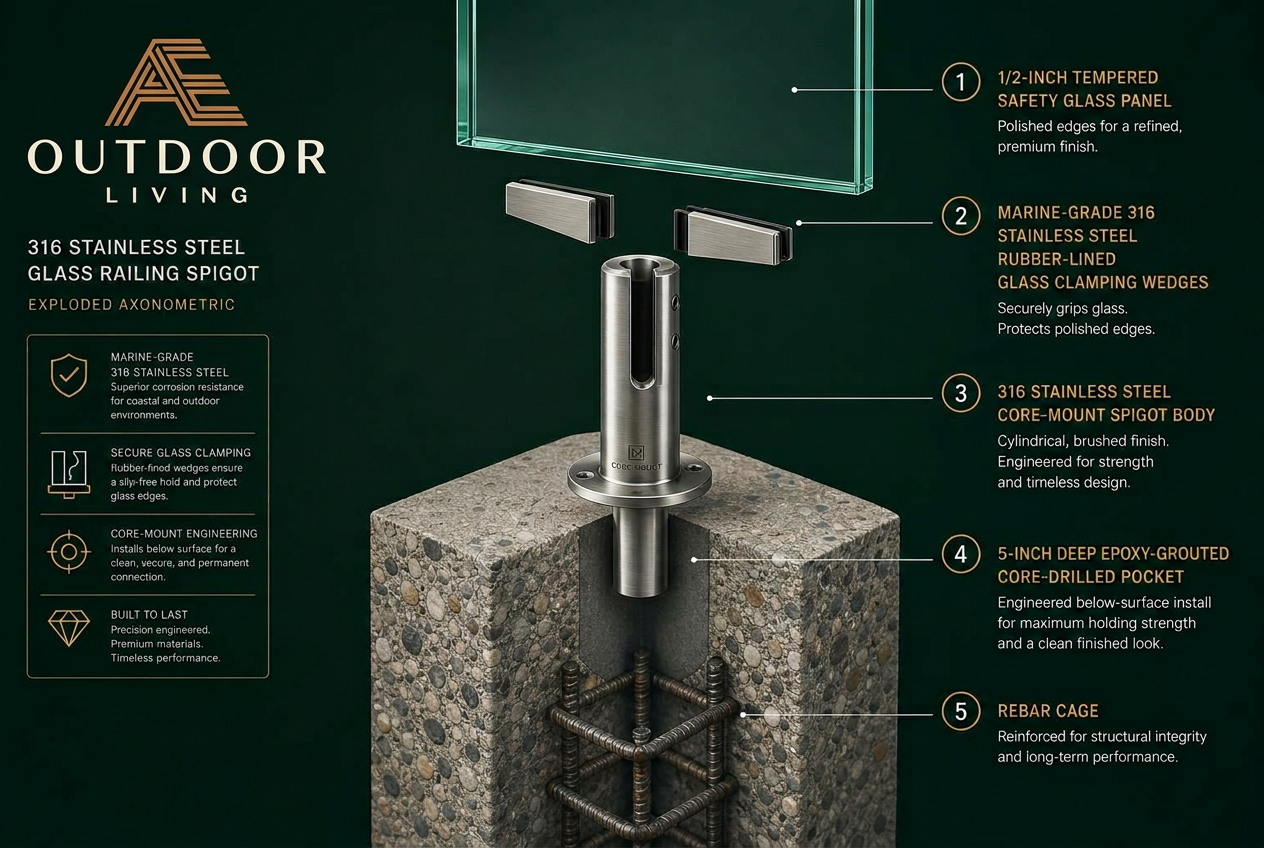

Exploded axonometric of a core-mount stainless-steel glass spigot embedded in a concrete footing with rebar cage, 1/2-inch tempered safety glass panel, and rubber-lined clamping wedges
Core-mount, done right. Epoxy-grouted pocket in a structural footing, Duplex 2205 stainless-steel spigot body, rubber-lined wedges, 1/2" heat-soaked tempered glass. The spigot becomes part of the concrete.

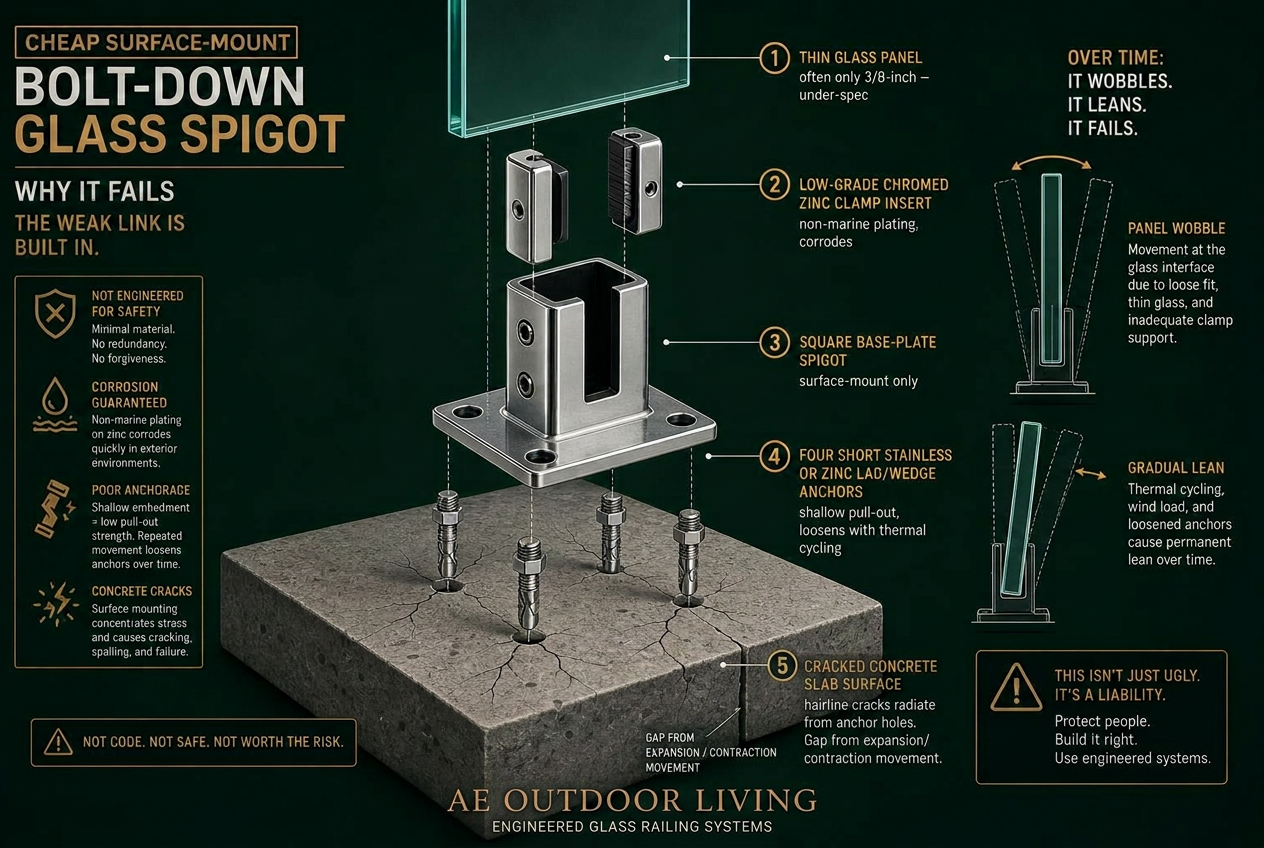

Exploded axonometric of a cheap Amazon bolt-down surface-mount glass spigot showing under-spec thin glass, low-grade chromed zinc clamps, shallow wedge anchors, and cracked concrete from expansion and contraction
Bolt-down, built to fail. Surface-mount base plate, four shallow wedge anchors, thin glass, low-grade chromed clamps. Thermal cycling loosens the anchors, the slab cracks at the heads, and the panel develops a permanent lean.

The visual difference is the embedment. The engineering difference is everything downstream of it — pull-out strength, load distribution, corrosion path, and how the assembly responds to concrete movement over a 25-year service life.

FAQ

Common questions.

Three things, stacked. First, they're surface-mounted with four short wedge or lag anchors — typically only 1.5–2 inches into the slab. That's nowhere near the pull-out strength of a properly embedded core-mount spigot set into a concrete footing. Second, the hardware is almost always low-grade stainless (often 201/304) or chromed zinc, not a chloride-resistant grade — so the clamp screws and base bolts pit and seize within 2–3 Arizona pool seasons. Third, the kits ship with 3/8" glass to keep the price down, which is thinner than the 1/2-inch tempered safety glass we use as our current standard. Cheap at the box, expensive at the failure.

Concrete moves. Pool deck slabs expand and contract every day with the Phoenix temperature swing (60–110°F surface temps are normal), and they move more across control joints. A core-mount spigot is embedded inside the concrete — the entire spigot, the grout, and the slab move as one mass, so the glass stays plumb. A surface-mount base plate sits on top of that movement: the slab flexes, the four anchors work back and forth in their holes, the holes get slightly oversized, and the panel develops a measurable lean. By year two you can usually push the top of the glass an inch or more out of plumb with one hand. That's not a finish problem — that's a barrier failure.

Not for a code-rated guard or pool barrier in Arizona. The IRC and IBC guard load requirement is a 200 lb concentrated load applied at the top of the railing, plus a 50 lb/ft uniform load. A properly embedded core-mount transfers that load into the full mass of a concrete footing. Four 3/8" wedge anchors into 4 inches of slab transfer it into a cracked cone of concrete that's already trying to lift. The math doesn't work — and that's before you add wind load, lean-into loads from adults, or a kid climbing on it. The reason you can buy these on Amazon is they're sold as 'decorative' railing, not code-rated barrier. Read the fine print.

Our current Sonoran Glass standard is Duplex 2205 stainless-steel spigots. Duplex 2205 has a higher chloride-pitting resistance number than common austenitic grades like 304, which is why we specify it around Arizona pool chemistry. Bolt-down import kits are typically 201/304 or chromed zinc, which tea-stain and pit quickly on a pool deck. Alternative stainless grades exist on other systems; the specific grade on your project is confirmed in writing in the signed proposal.

1/2-inch tempered safety glass is our current Sonoran Glass standard on every install. Two reasons. (1) The deflection at the top of a 42–48" panel under a 200 lb load is meaningfully larger on 3/8" glass — it feels flimsy when you lean on it, even if it doesn't break. (2) Edge strength: tempered glass is strongest in the face and weakest at the edge. The thicker the panel, the more edge cross-section is carrying the clamp load. 3/8" panels chip at the clamp interface more often, and a chipped tempered edge is the start of spontaneous failure.

For railing purposes they're effectively equivalent (12mm = 0.472", 1/2" = 0.500"). Imported European panels are almost always 12mm; domestic US fabrication is 1/2". AE's current Sonoran Glass standard is 1/2-inch tempered. What matters on any panel is the certification stamp in the corner — heat-soaked tempered safety glass with an embedded ANSI Z97.1 or CPSC 16 CFR 1201 Cat II stamp. No stamp, no install.

Not really. You can re-torque the base bolts, but the anchor holes are already oversized from the cyclic loading — they won't hold the next time. Some installers epoxy-fill the old holes and re-drill, which buys a year or two. The real fix is to core-drill new pockets next to the old base plates, install proper core-mount spigots, grout them in, and remove the failed bolt-down hardware. At that point you've paid twice. This is the most common rescue call we get on glass railing.

Deep enough to reach a structural pour (footing, beam, or properly thickened slab edge). The pocket is filled with structural epoxy grout (not hydraulic cement, not non-shrink grout in a tube — two-part structural epoxy), and the spigot is set plumb and held until cure. In a thin existing pool deck slab, we will not core-mount — we'll either pour a new footing or use a different engineered anchoring approach. Final embedment depth, mounting method, engineering and any specialty conditions are project-specific and confirmed in the signed proposal.
